Construction Process Standards for Steel Structures (Steel Frames)

2026-10-19 0 Leave me a message

1. Steel Frame Lifting Check (Hoisting Calculation)

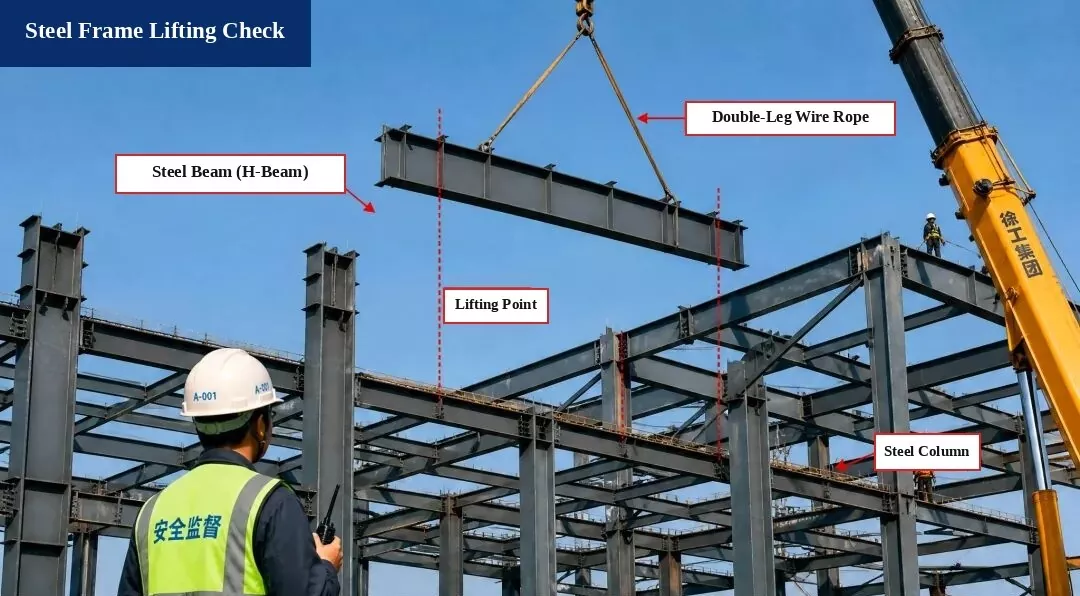

Steel beam lifting operation

Extracted Photo Labels: Lifted Part: Steel Beam (H-Beam) | Lifting Sling: Double-Leg Wire Rope Sling | Lifting Point Position | Steel Frame Column | Safety Supervisor (Helmet A-001) | Crane: XCMG Group

I. Lifting Diagram

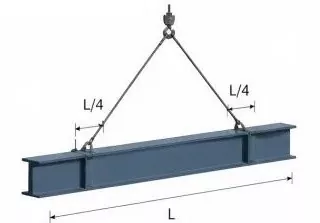

Steel beam lifting diagram

Member: Steel Beam H500×200×10×16, Length L = 12.0 m

Lifting Points: Set at L/4 from each end of the beam

Sling Angle: α ≈ 60°

II. Load Calculation

1. Self-Weight of Beam:
G = ρ × V = 78.5 kN/m³ × 0.212 m³/m × 12.0 m = 199.9 kN

2. Dynamic Load Factor: Take 1.1

3. Weight of Slings: Ignored (negligible)

4. Total Lifting Load:
P = G × 1.1 = 219.9 kN

5. Sling Tension (Balanced Load):
T = P / (2 × cos α) = 219.9 / (2 × cos 60°) = 219.9 kN

III. Sling Safety Check

1. Sling Type: φ20 steel wire rope, breaking load Fb = 360 kN

2. Safety Factor (n):
n = Fb / T = 360 / 219.9 = 1.64 > 1.25

Meets standard requirements!

Check Conclusion:
The lifting operation is safe and meets code requirements.

Reference Standards

• Code for Construction of Steel Structures (GB 50755-2012)

• Technical Code for Safety of Lifting and Hoisting in Construction (JGJ 276-2012)

Safety Notes:

1. Check the steel beam, wire ropes, and lifting tools before lifting to make sure they are safe and reliable.

2. Assign a dedicated person to direct the lifting process. No one may stand under the lifted beam.

3. Stop lifting work immediately when wind speed reaches Level 6 or higher.

2. Steel Frame Installation and Inspection — Steel Beam Installation

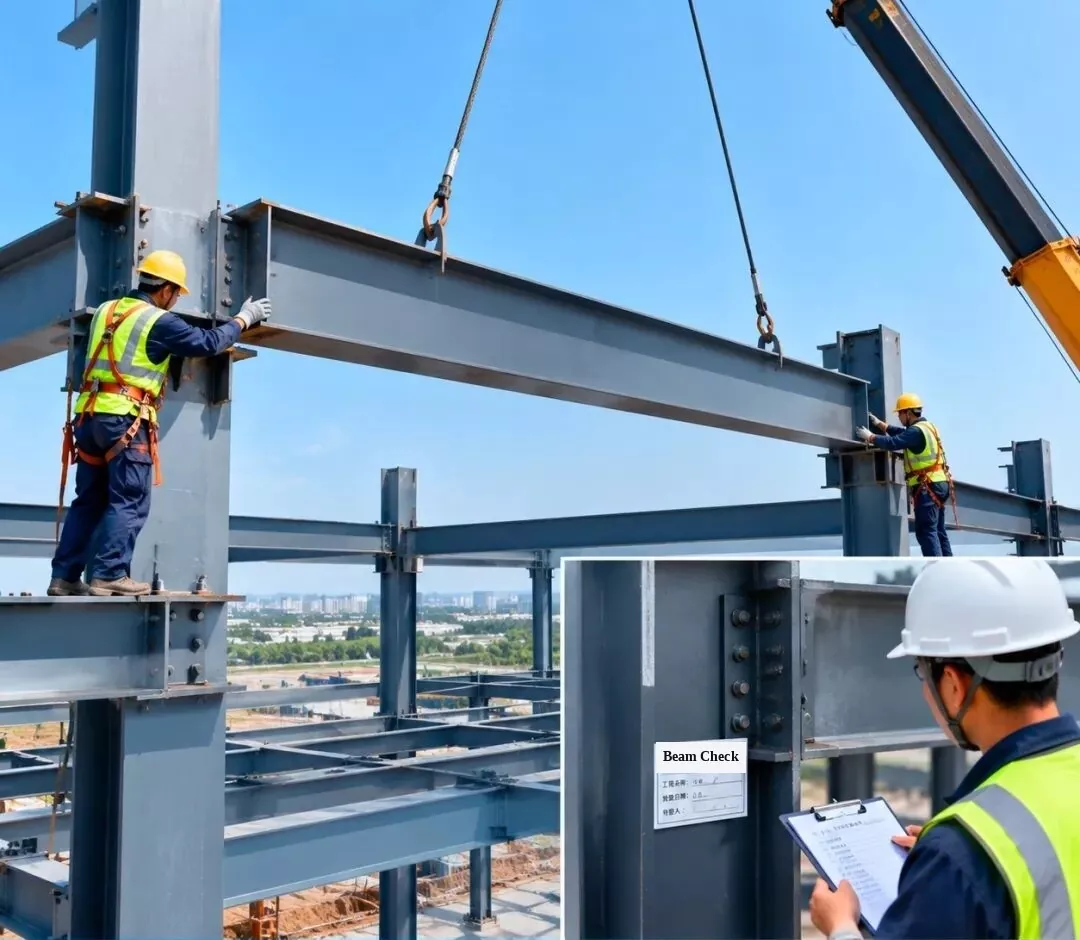

Steel beam installation and inspection

Lift the steel beam into its planned position, then inspect and approve the connection joints to make sure the installation quality meets design requirements.

[Inset Tag on Column: Steel Beam Installation Inspection | Project Name: Workshop #1 | Inspection Date | Inspector]

3. Steel Frame Installation and Inspection — Steel Roof Truss Installation

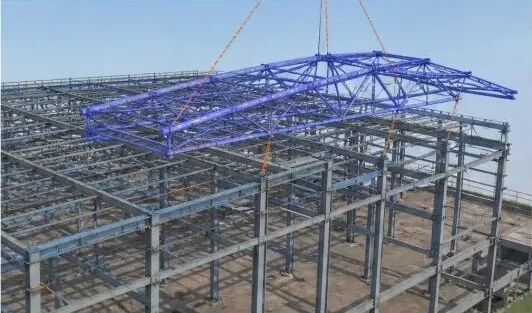

3D BIM simulation1. 3D BIM Simulation: Simulate the steel roof truss installation to improve the lifting plan and installation order.

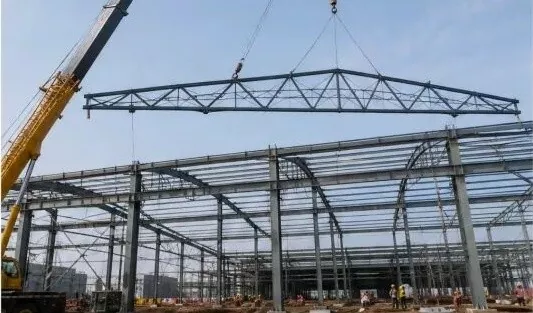

Roof truss lifting2. Roof Truss Lifting: Use a truck crane to lift the truss and place it slowly into position while keeping it balanced.

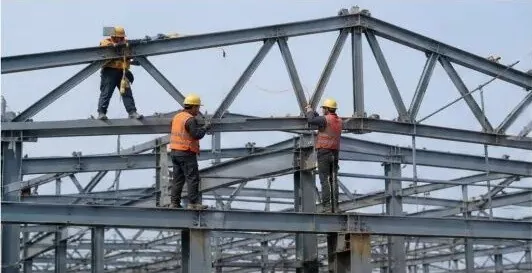

Positioning and temporary fixing3. Positioning & Temporary Fixing: After the roof truss is in place, secure it temporarily and adjust its position and height (elevation).

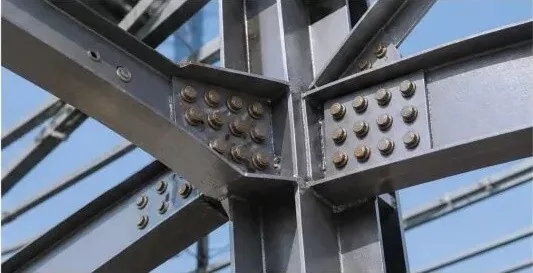

High-strength bolt connection4. High-Strength Bolt Connection: Tighten the high-strength bolts according to the design rules to ensure a strong connection.

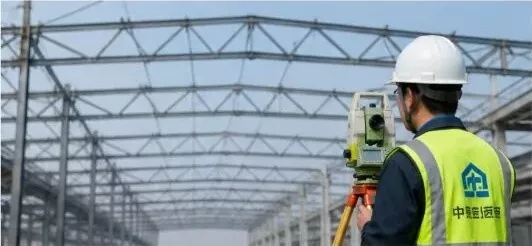

Truss installation inspection5. Installation Inspection: Check the truss height, span, bending (deflection), and vertical alignment to make sure they meet the code.

Truss inspection record6. Inspection Record: After passing the inspection, complete the record form and move on to the next construction step.

Steel Roof Truss Installation Inspection Record

Inspection Item Allowed Error (mm) Measured Value (mm) Check Result
Truss Span (L) ±10 — √ (Pass)
Truss Height (Elevation) ±5 — √ (Pass)
Truss Bending (Deflection) L / 750 — √ (Pass)
Truss Vertical Alignment H / 1000 — √ (Pass)
Support Position ±5 — √ (Pass)
High-Strength Bolt Torque Meets design requirements — √ (Pass)
Key Control Points:
  1. Check all incoming steel parts on site to verify their type, size, and weld quality;
  2. Use a safe and practical lifting plan to ensure lifting safety;
  3. Adjust and fix the truss right after it is placed in position;
  4. Tighten all high-strength bolts properly and test their torque according to the code;
  5. Carry out a full inspection to make sure the installed structure meets all design and code requirements.

4. Steel Frame Installation and Inspection — Inclined Steel Beam Installation

Inclined steel beam installation

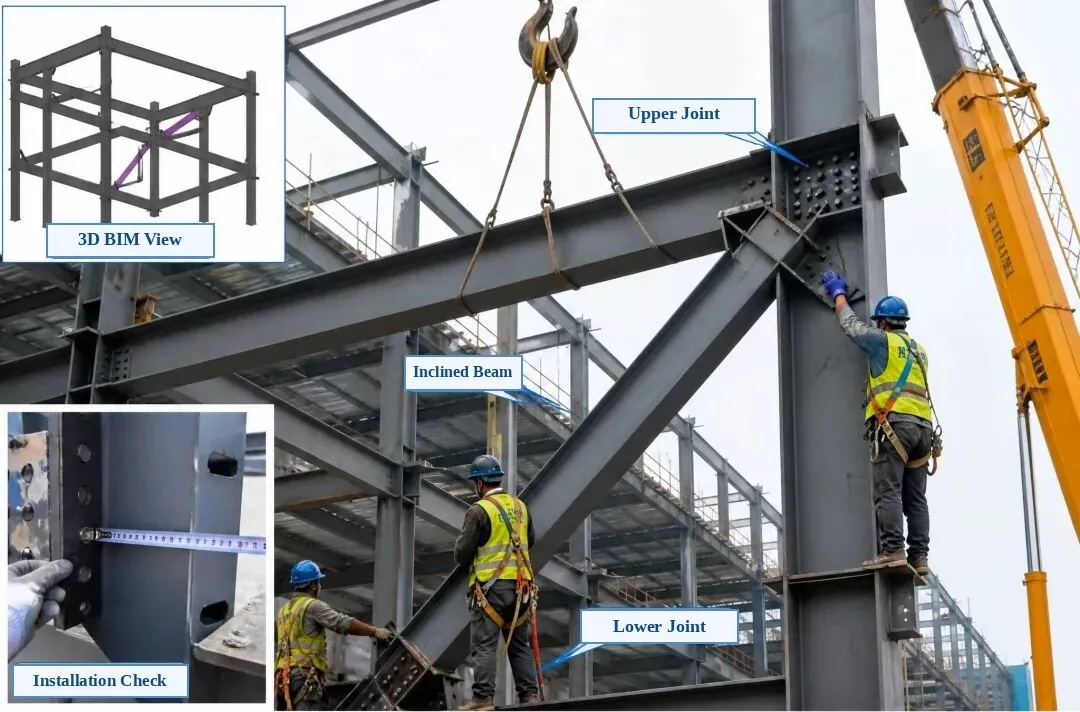

Extracted Photo Labels: Top-Left Inset: 3D BIM View | Bottom-Left Inset: Installation Check | Main Photo: Upper Connection Joint, Inclined Steel Beam (Diagonal Brace), Lower Connection Joint

Steel Frame Installation and Inspection — Inclined Steel Beam Installation

1. Pre-Installation Check: Check the part number, size, bolt hole positions, and connection plate direction. Make sure the contact surfaces are flat, clean, and free of burrs or oil.

2. Lifting and Positioning: Use two lifting points to lift the inclined beam slowly into place. Fix it temporarily and make sure both the upper and lower joints line up accurately with the steel column and beam.

3. Alignment and Adjustment: Adjust the centerline position, height, and vertical alignment of the inclined beam to meet design requirements. Complete the permanent connection after alignment.

4. Connection Method: Connect with high-strength bolts. Tighten them evenly from the center outward to both sides as required by the design, and mark each bolt after final tightening passes inspection.

5. Installation Inspection: Check the centerline position, height, vertical alignment, plate contact tightness, and bolt tightening quality. Everything must meet the Code for Acceptance of Construction Quality of Steel Structures (GB 50205).

5. Steel Frame Installation and Inspection — Steel Column Installation

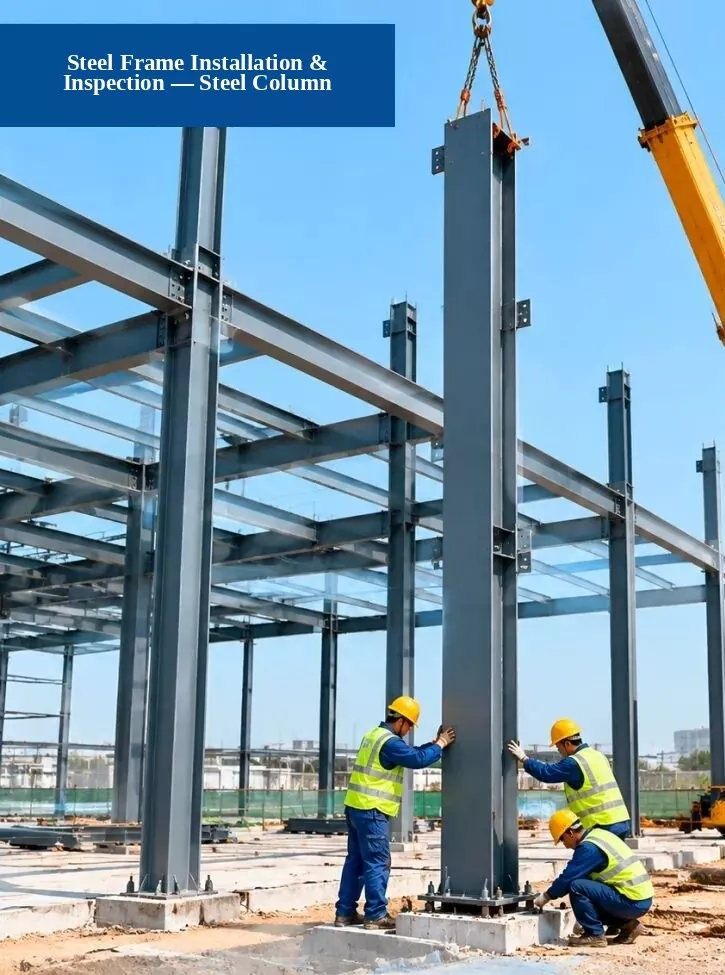

Steel column installation
Foundation check

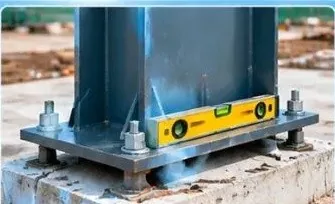

1. Foundation Check: Check whether the anchor bolt positions, foundation height, and foundation dimensions meet the design requirements.

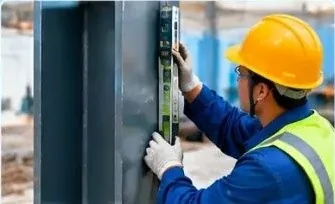

Vertical alignment check

2. Vertical Alignment Check: Use a total station, laser plumb, or straightedge level to check how straight (vertical) the steel column stands.

Connection quality check

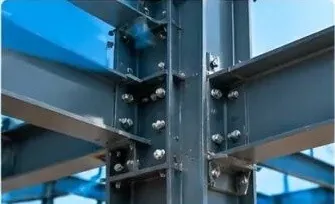

3. Connection Quality Check: Check whether the high-strength bolts, welds, and connection plates meet the standard requirements.

Construction Process: 1. Preparation Work → 2. Lift & Place Steel Column → 3. Install & Secure → 4. Inspection & Acceptance

6. Steel Frame Installation — Truss Structure Installation (3D BIM Diagram)

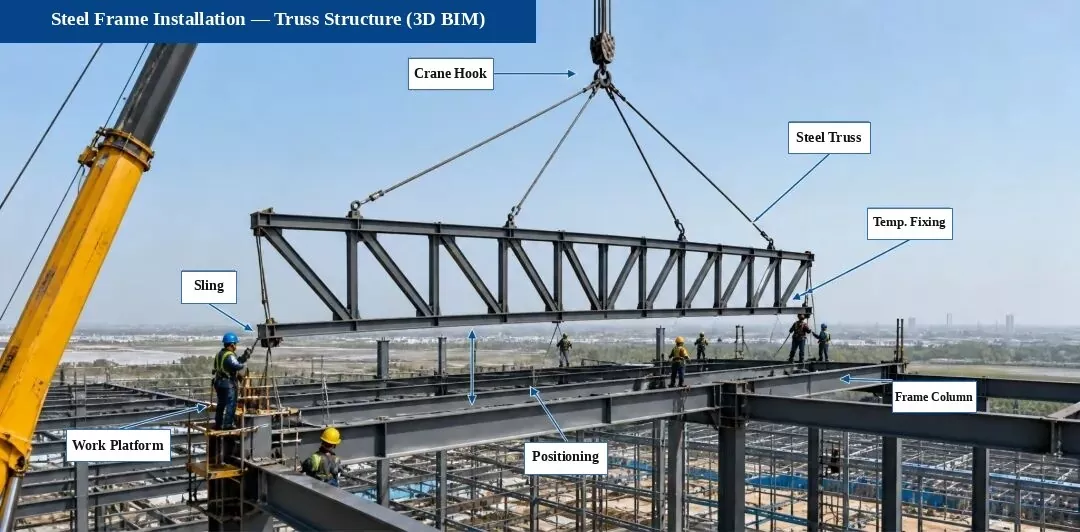

Truss structure lifting and placement

Extracted Photo Labels: Crane Hook | Steel Truss Structure | Temporary Fixing | Lifting Sling | High-Work Platform | Place in Position | Steel Frame Column

Installation Process Flow: Survey & Marking → Support Check → Lift & Place → Temporary Fixing → Alignment & Adjustment → High-Strength Bolt Connection → Welding (if required)

Key Installation Points:
  1. Before lifting, double-check the support centerline, height, and embedded part positions;
  2. Attach wind guide ropes (taglines) during lifting to keep the truss stable;
  3. Adjust and temporarily secure the truss right after placement to prevent bending or distortion;
  4. High-strength bolt connections must follow design and code rules and be tightened to the required torque;
  5. Weld quality must meet the rules in the Code for Acceptance of Construction Quality of Steel Structures (GB 50205).

Key Inspection Points (Site Photos):

1. Support & Joint Check

Support and joint check

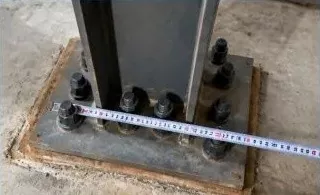

Check the positions and heights of support bolts, shim plates, and embedded parts to make sure they meet design requirements.

2. Truss Alignment Check

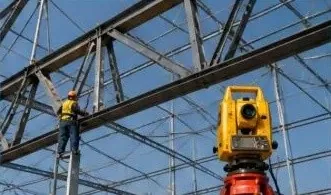

Truss alignment check

Use a total station to measure the centerline, height, and bending of the truss, and make alignment adjustments.

3. High-Strength Bolt Check

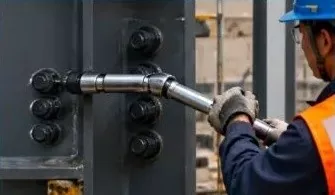

High-strength bolt check

Check the number, size, and torque of the high-strength bolts, and re-test them as required by the code.

Note: The truss structure in this project is pre-assembled in the factory and lifted in sections on site to ensure accurate installation, quality, and safety.

7. Steel Frame & Profiled Metal Roof Sheet Installation and Inspection

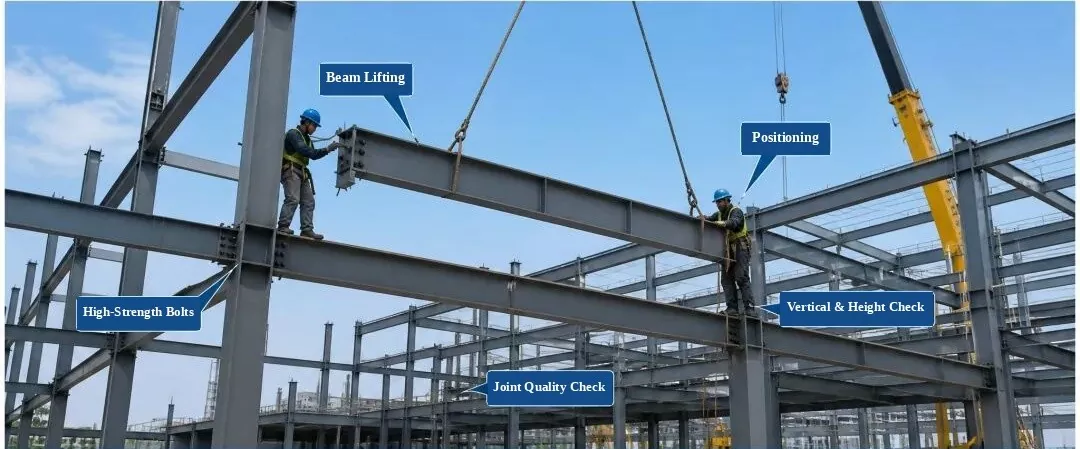

Steel frame installation and inspection

Steel Frame Installation and Inspection

(Labels: Beam Lifting, Positioning, High-Strength Bolts, Vertical & Height Check, Joint Quality Check)

1. Incoming Part Check: Check the material quality, size, surface condition, and straightness. Install only after passing inspection.

2. Process Control: Control part positioning, height, vertical alignment, and bolt tightening during installation.

3. Inspection Items: Centerline position, height, vertical alignment, surface flatness, and bolt connection quality.

4. Quality Standard: Must meet the Code for Acceptance of Construction Quality of Steel Structures (GB 50205-2020).

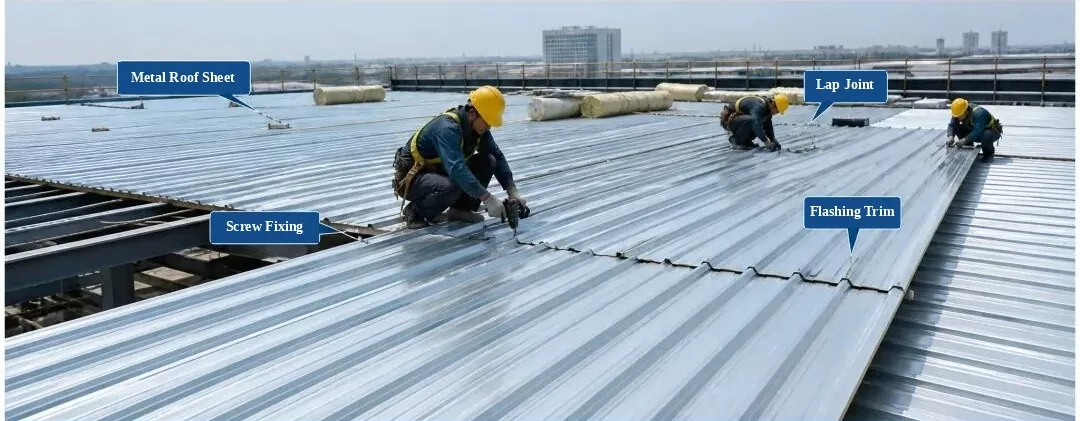

Profiled metal roof sheet installation

Profiled Metal Roof Sheet Installation & Inspection

(Labels: Metal Roof Sheet, Lap Joint, Self-Tapping Screw Fixing, Flashing Trim)

1. Material Check: Check the panel profile, thickness, coating, and color. Use only after passing inspection.

2. Installation Rules: Overlap the panels correctly and fix them firmly. Keep screw spacing within standard limits, with no missing or misplaced screws.

3. Inspection Items: Roof flatness, overlap width, fastening point spacing, and waterproofing details.

4. Quality Standard: Must meet the Technical Code for Metal Roof Engineering (GB 50345-2012).

8. Steel Frame Installation and Inspection — Steel Stairs and Handrail Installation

Completed steel stairs and handrails1. Completed Steel Stairs and Handrails (Site Photo)

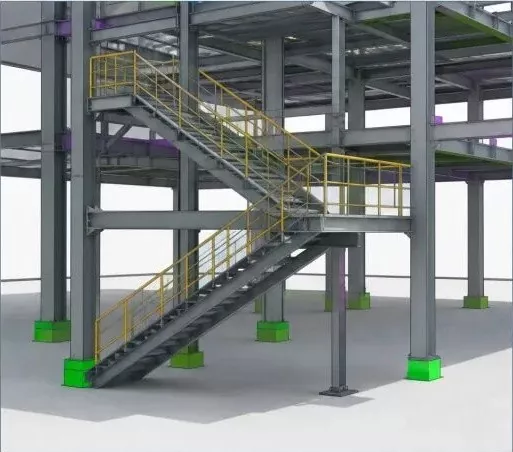

3D BIM model of steel stairs2. 3D BIM Model (Steel Stairs and Handrails)

Steel stair installation3. Steel Stair Installation (Site Work)

Handrail installation4. Handrail Installation (Site Work)

Installation quality inspection5. Installation Quality Inspection (Site Check)
Instructions:
  1. Before installing steel stairs and handrails, double-check the component dimensions, heights, and layout centerlines;
  2. When using bolted connections, check the bolt size, quantity, and torque to ensure a firm connection;
  3. Installed handrails must be firm and straight, with full and smooth welds that meet design and code requirements;
  4. Carry out a quality inspection after installation and fill out the inspection record to ensure project quality.

Construction Process Standards for Steel Structures (Steel Frames)

Steel structures are widely used in today's construction market to build building frames, and they will become the main choice for primary building structures in the future. Steel structures have many sub-categories, structure types, and component types. Based on the structural system, they are divided into four main types: portal frames, space grids, trusses, and frame structures.
